メインコンテンツ

Perform Grouped Estimation of Model Parameters for Single-Particle Battery Model

R2026b

This example shows how to estimate the parameters of a single-particle model with electrolyte dynamics (SPMe) of a Li-ion battery. You estimate the model parameters to match the voltage output of the battery model to a measured voltage response.

You first use the Sensitivity Analyzer app to evaluate the influence of the model parameters on the match between the model output and the measured data and then group the model parameters based on the strength of their influence. Finally, you use the Parameter Estimator app to estimate the parameters in groups, in a sequence of decreasing influence.

Single-Particle Battery Model

Load the Simulink® model data in the workspace.

load("sdoSPMBattery_data.mat");

Open the model.

open_system('sdoSPMBattery');

Single-Particle Battery Model

The sdoSPMBattery model simulates the battery terminal voltage in response to a hypothetical dynamic pulsed current profile. You use the Battery Single Particle block from Simscape™ Battery™ to model the battery behavior in the simulation. To simulate the model, click Run. To view the input current and the output terminal voltage, double click the Scope block.

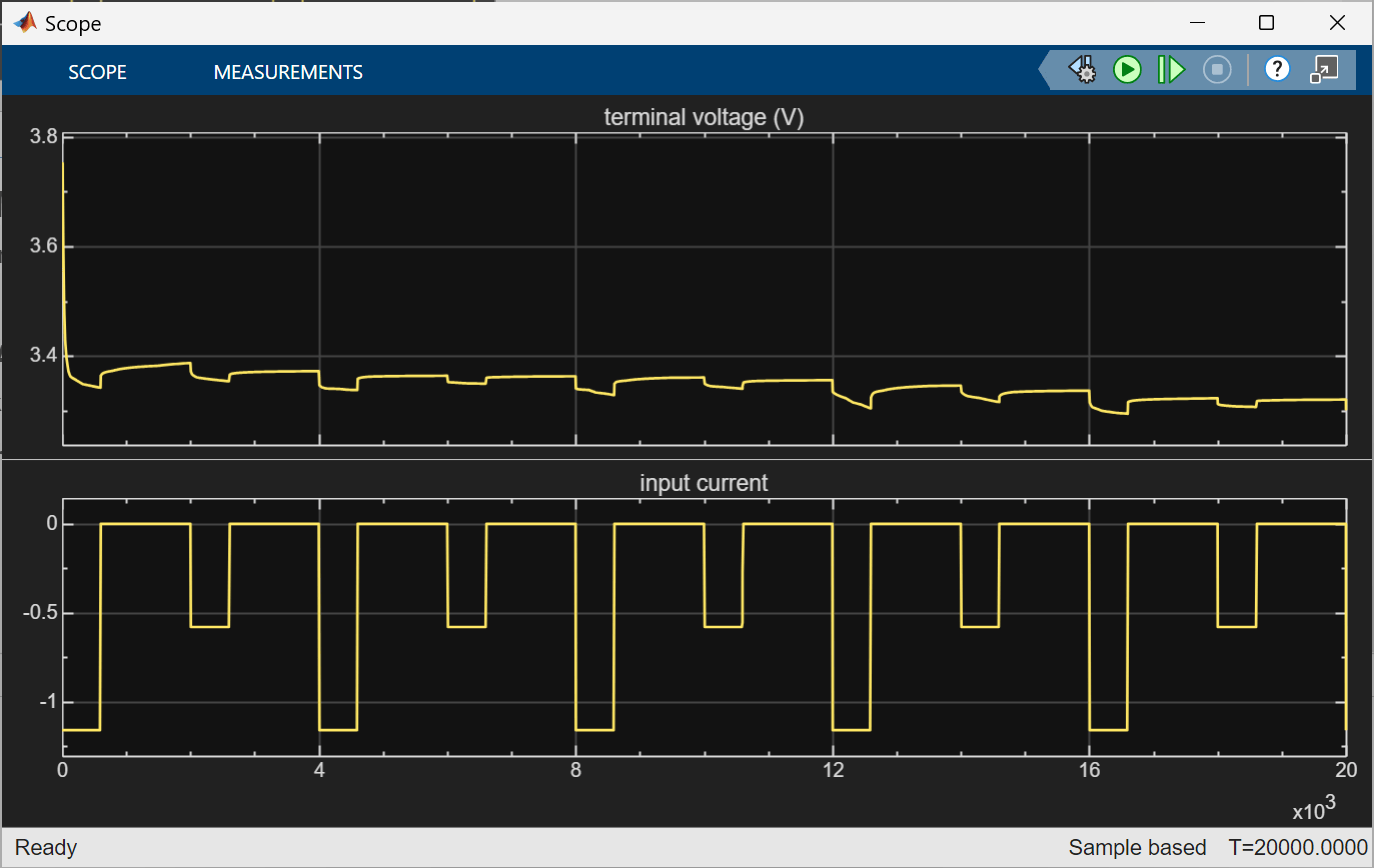

Scope block displaying the input current and output terminal voltage

The Battery Single Particle block implements an electrochemical model for Li-ion batteries. It is a simplified electrochemical model that follows a typical single-particle model with electrolyte dynamics (SPMe) framework. For more information on the single-particle approach to model a battery, see the documentation for the Battery Single Particle block from Simscape Battery.

There are lots of parameters associated with an electrochemical model for Li-ion batteries. These parameters can be related to the cell design, the cell equilibrium (or static) behavior, and the cell dynamic behavior. In this example, you estimate the following battery design parameters for the model:

  • The Cathode Particle Radius (CPR), with a baseline value of 5×10-8, ranging from a minimum of 4×10-8 (CPR_min) to a maximum of 6×10-8 (CPR_max).

  • The Anode Particle Radius (APR), with a baseline value of 5×10-6, ranging from a minimum of 4×10-6 (APR_min) to a maximum of 6×10-6 (APR_max).

  • The Cathode Diffusion Coefficient (CDC), with a baseline value of 5.9×10-20, ranging from a minimum of 101.02×log10(5.9×10-20) (CDC_min) to a maximum of 100.98×log10(5.9×10-20) (CDC_max).

  • The Anode Diffusion Coefficient (ADC), with a baseline value of 3×10-15, ranging from a minimum of 101.02×log10(3×10-15) (ADC_min) to a maximum of 100.98×log10(3×10-15) (ADC_max).

To avoid a degenerate solution to the parameter estimation, the model uses an input current profile that is created by superimposing two pulsed current profiles of different amplitudes. However, you can use a different current profile based on the nature of the estimation problem. It is generally important and necessary to carefully design a current profile such that the measured voltage encodes enough information for estimating battery model parameters. Although there may be scope for current profile optimization in this kind of model parameter estimation project, this example assumes that the superimposed pulsed current profile is the one selected and focuses on demonstrating the workflow of sensitivity analysis and parameter estimation.

Group Model Parameters Using Sensitivity Analysis

Perform sensitivity analysis to group the model parameters according to the influence of the model parameters on the fit of model response to experimental data. You use such grouping to perform group-wise parameter estimation where the model parameters with higher sensitivities are estimated before those with lower sensitivities.

Specify Design Variables and Generate Analysis Values

To open the Sensitivity Analyzer app, in the Simulink model window, in the Apps gallery, click Sensitivity Analyzer.

In the Sensitivity Analysis tab, in the Select Parameters drop-down list, select New. To create a parameter set that includes the model design parameters, in the Select Parameters dialog box, select ADC, APR, CDC,and CPR, and click OK. The parameter set appears as ParamSet under the Parameter Sets section of the app.

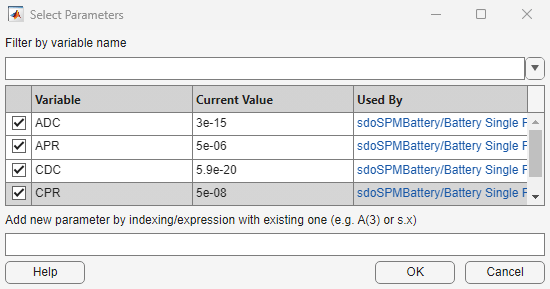

Select Parameters dialog box showing the selected parameters

Create random parameter values to evaluate. Select ParamSet and in the Sensitivity Analysis tab, in the Generate Values drop-down list, select Generate Random Values.

In the Generate Random Parameter Values dialog box, specify the Number of Samples as 50. In the Sampling Method menu, select Latin Hypercube. The Latin Hypercube method provides a more systematic and uniform coverage of the parameter space compared to the Random method.

In the Distribution Parameters section, for each parameter, select the Distribution as Uniform and enter its minimum and maximum values in the Lower and Upper text boxes, respectively. Click OK.

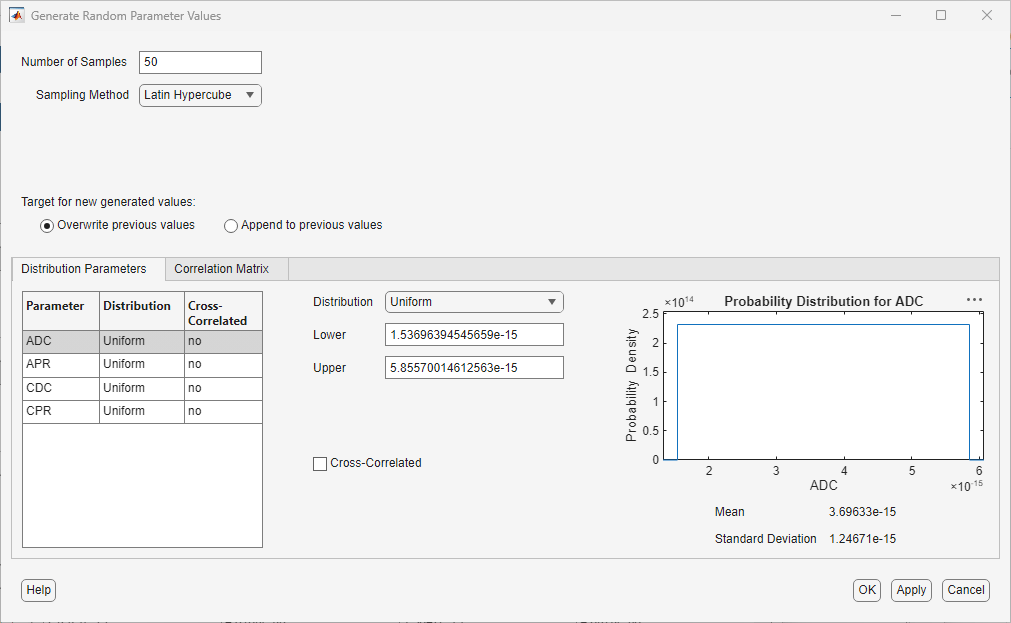

Generate Random Parameter Values dialog box showing the parameter distributions

The app populates the parameter set paramSet with the parameter combinations.

For more information on generating random parameter values, see Generate Random Parameter Values.

Add Signal Matching Requirement

Create a requirement to match the model response to the experimental data. In the Sensitivity Analysis tab, in the New Requirement drop-down list, select Signal Matching. To associate the measured voltage data with the voltage output of the model, in the Edit Signal Matching: SignalMatching dialog box, under the Outputs section, click Select Signals and in the Select Outputs dialog box, select the terminal voltage (V) output of the Probe block and click OK. Configure the measured data by populating the Time field as VoltageMeasTime and the Data field as VoltageMeasData. Note that the measured data used in this example is hypothetical and only for demonstrative purposes. Under the Inputs section, delete the selected input signal by clicking the delete button. Click Close.

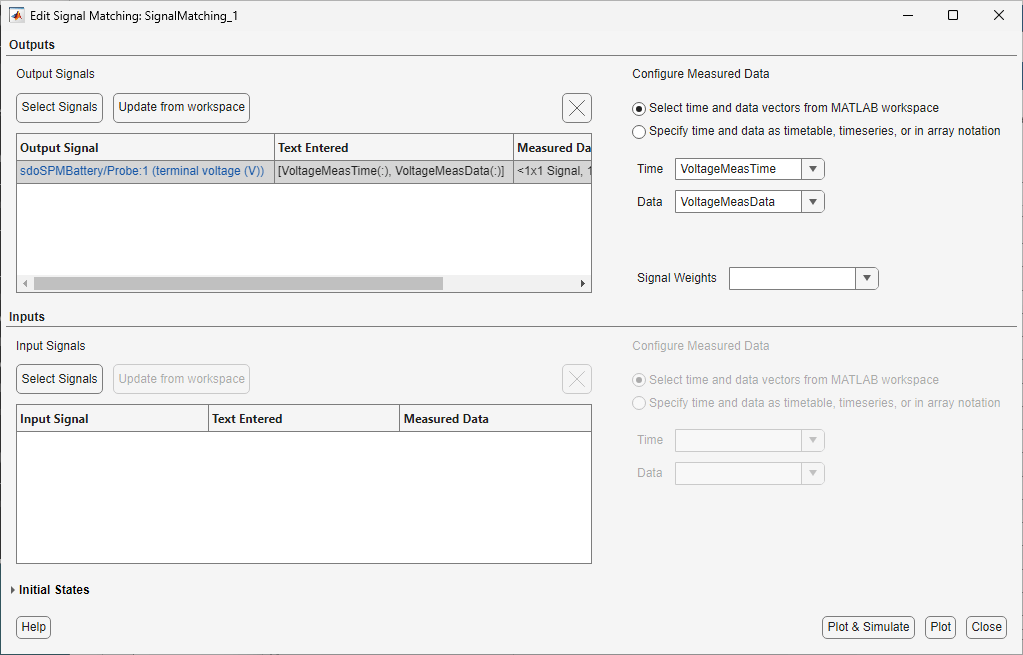

The Edit Signal Matching dialog box showing the Outputs and Inputs sections

A new requirement, SignalMatching, appears in the Requirements section of the app. Rename the requirement as VoltageMatching by slowly double-clicking on it.

Perform Sensitivity Analysis and Group the Model Parameters

To evaluate the requirement values at the different parameter values in ParamSet, in the Sensitivity Analysis tab, click Evaluate Model. The results appear as a new evaluation result EvalResult in the Results section of the app.

Compute the sensitivity of the VoltageMatching requirement to model parameters. In the Statistics tab:

  • In the Evaluation Result to Analyze drop-down list, select EvalResult.

  • For the Method, select Correlation.

  • For the Type, select Linear.

Click Compute Statistics. A new statistics result, StatsResult, appears in the Results section of the app. Also, a tornado plot appears in the app that visualizes the influence of the model parameters on the VoltageMatching requirement. You can also create the tornado plot by selecting StatsResult and clicking Tornado Plot in the Plots tab.

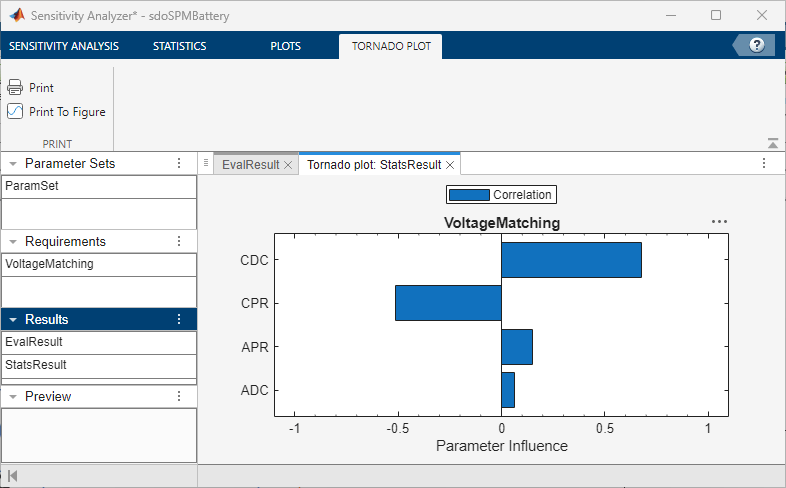

The Sensitivity Analyzer app displaying the Tornado plot of StatsResult

Now, divide the model parameters into groups based on the relative magnitude of their influence on the VoltageMatching requirement. For this example, divide the model parameters into two groups:

  • The "High-Sensitivity" group consisting of the parameter CDC and CPR.

  • The "Low-Sensitivity" group consisting of the parameters ADC and APR.

Note that you can use a different grouping criteria based on the number of parameters, the influence of parameters on the design requirements, and the nature of the estimation problem.

Determine Initial Guess for Parameter Estimation

To view the evaluation result table, in the Results section of the app, right-click EvalResult and click Open.

Sort the rows by their values in the VoltageMatching column by hovering over the column header and clicking the arrows on the right of the header. Select the row with the lowest value in the VoltageMatching column. This row shows the combination of parameters that results in the best match between the model response and the experimental data.

Right-click the selected row and click Extract design point. The extracted parameter values ParamValues appear in the Results section of the app. To reduce the number of iterations during parameter estimation, use ParamValues as the initial guess.

To directly view the sensitivity analysis results obtained in this example, open the session sdoSPMBattery_sasession.mat.

Estimate Model Parameters

Perform group-wise estimation of model parameters.

Create Parameter Estimation Session

In the Sensitivity Analysis tab, in the Optimize drop-down list, click Create Parameter Estimation Session. The Parameter Estimator app opens along with the Parameter Estimation - Import from Sensitivity Analysis dialog box. In the Select parameter values to import as initial guess menu, select ParamValues. In the Select experiments to Import section, select the VoltageMatching experiment and click OK.

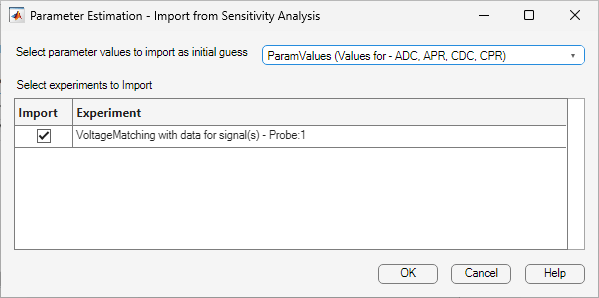

Parameter Estimation - Import from Sensitivity Analysis dialog box showing the selected parameter values and experiments to import

The app extracts the initial guesses for the ADC, APR, CDC, and CPR parameters from ParamValues and populates them in the Parameters section of the Parameter Estimator app. VoltageMatching appears in the Experiments section of the app. An experiment plot for the VoltageMatching experiment also appears in the app. Right-click the VoltageMatching experiment and click Plot measured and simulated data. Observe the initial mismatch between the measured data and the model response with the baseline parameter values.

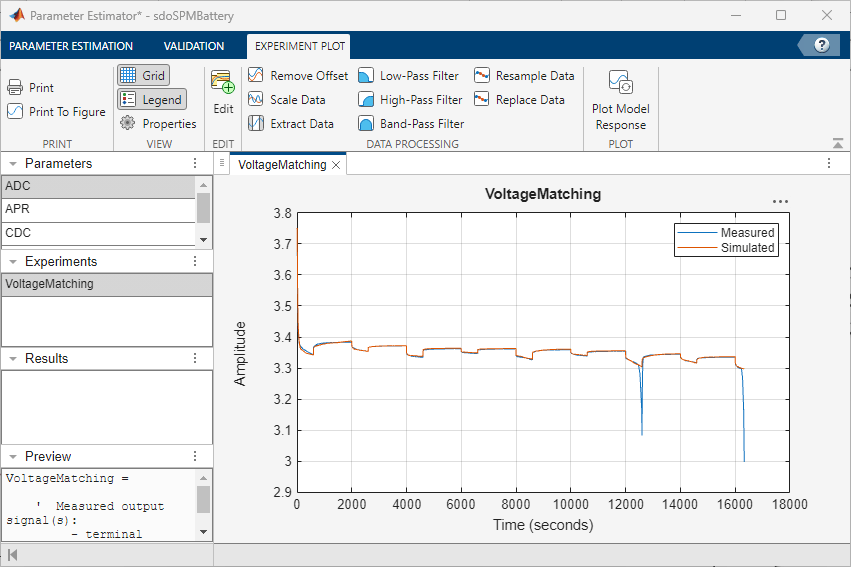

The Parameter Estimator app displaying a plot of the measured and simulated data for the VoltageMatching experiment

On the Parameter Estimation tab, click Select Parameters. In the Edit: Estimated Parameters dialog box, observe that the app populates the initial, minimum, and maximum values of the parameters from the initial guess imported from sensitivity analysis. Click Close.

Configure the optimization options. In the Parameter Estimation tab, in the More Options drop-down list, select Optimization. Use the estimation options editor dialog box to choose the solver and the algorithm, and tune the stopping criteria for the solver. For this example, in the Estimation Options dialog box, under the Optimization tab, set the Method to Nonlinear least squares and the Algorithm to Trust-Region-Reflective. Click OK.

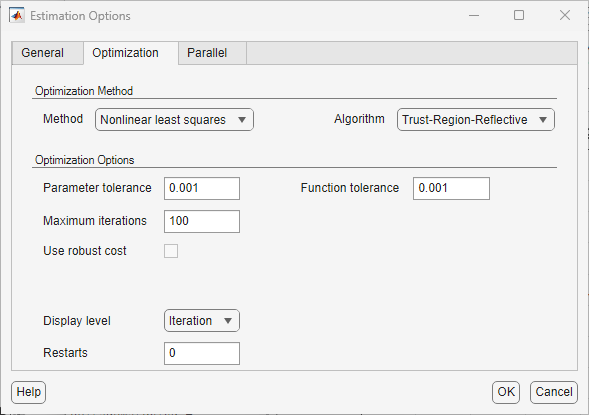

Estimation Options dialog box showing the Optimization tab

Estimate High-Sensitivity Parameters

Estimate the high-sensitivity parameters to get a better initial guess for them. These are the parameters that most influence the matching of model output to measured data.

To open the Edit: Estimated Parameters dialog box, double-click a parameter in the Parameters section. To estimate the high-sensitivity parameters, clear the Estimate check box for the parameters ADC and APR. Keep the Estimate check box selected for the CDC and CPR parameters. Click Close.

In the Parameter Estimation tab, click Estimate.

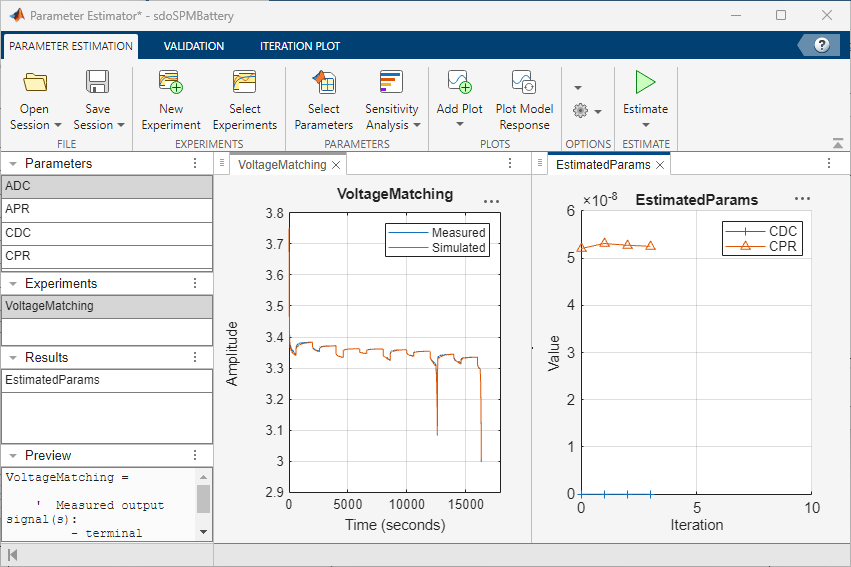

The Parameter Estimator app displaying the parameter trajectory plot and the experiment plot for the VoltageMatching experiment after estimating high-sensitivity parameters

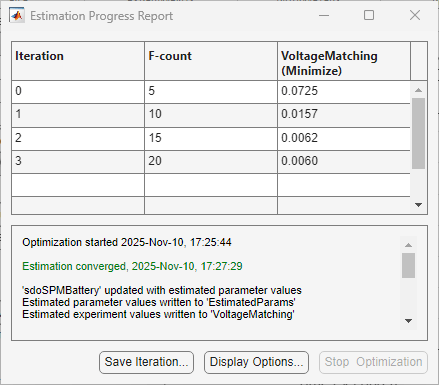

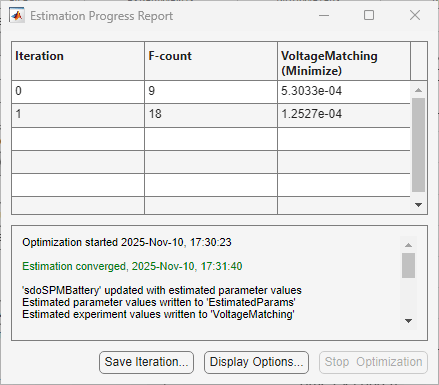

Estimation Progress Report dialog box

The estimation converges with the high-sensitivity parameters (CDC and CPR) tuned to best fit the simulation data to the measured data while keeping the low-sensitivity parameters (ADC and APR) unchanged. After the estimation, a new evaluation result, EstimatedParams, appears in the Results section of the app.

Estimate High-Sensitivity and Low-Sensitivity Parameters

With the initial value of the high-sensitivity parameters estimated, now estimate high-sensitivity and low-sensitivity parameters together.

To open the Edit: Estimated Parameters dialog box, double-click a parameter in the Parameters section. To estimate the low-sensitivity parameters, select the Estimate check box for the parameters ADC and APR. Keep the Estimate check box selected for the CDC and CPR parameters. Click Close.

In the Parameter Estimation tab, click Estimate.

The Parameter Estimator app displaying the parameter trajectory plot and the experiment plot for the VoltageMatching experiment after estimating both high-sensitivity and low-sensitivity parameters

Estimation Progress Report dialog box

The estimation converges with both the high-sensitivity parameters (CDC and CPR) re-tuned and the low-sensitivity parameters (ADC and APR) tuned to best fit the simulation data to the measured data. Note that the improvement in the fit is small, indicating that the initial values of the high-sensitivity parameters are well tuned.

The software updates the evaluation result EstimatedParams with the newly estimated parameter values.

To directly view the parameter estimation results obtained in this example, open the session sdoSPMBattery_spesession.mat.

Close the model.

close_system('sdoSPMBattery');

Summary

This example presents the workflow to perform sensitivity-based group-wise parameter estimation of model parameters. In this approach, you perform a preliminary tuning of high-sensitivity parameters before performing a final parameter estimation of all model parameters. The preliminary tuning results in a better initial guess for the high-sensitivity parameters, which can help the final estimation session converge faster.

You can apply the approach demonstrated in this example to a variety of other parameter estimation scenarios with a larger number of parameters and complex models.

See Also

Topics
