メインコンテンツ

Response Optimization with Simscape Models

R2026b

This example shows how to tune the value of a resistor and maximize the power transferred from one part of an electric circuit to another by using the Response Optimizer app. It uses an electric circuit which is entirely modeled using Simscape™ and does not have any Simulink® signals. The example shows Simulink Design Optimization™ directly interacting with Simscape. For example, you can specify the power-transfer requirement by clicking on the corresponding Simscape block.

Open the Simulink model.

open_system('sdoImpedanceMatch')

Model of an electric circuit

The source resistance, Rs, is 50 ohms. To maximize the power transferred from the source to the load, you adjust the load resistance parameter, R_load.

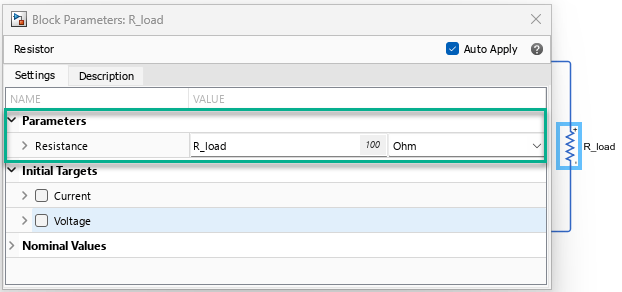

The Block Parameters: R_load dialog box showing the value if the load resistance parameter

To open the Response Optimizer app from the model, in the Simulink model window, in the Apps gallery, click Response Optimizer.

Set Up the Optimization Problem

To maximize the power transferred to the load, create a new signal property requirement. In the Response Optimization tab, in the New drop-down list, select Signal Property. To specify the signal associated with the requirement, in the Create Requirement dialog box, in the Select Signals area, click the Add button. In the model, click the load resistor, R_load. This populates the Create Signal Set dialog box with the Simscape variables possible for the load resistor. Select the power dissipated and click OK.

The Create Signal Set dialog box showing the selected Simscape variable

In the Create Requirement dialog box, rename the requirement as MaxPowerTransfer. In the Specify Signal Property area, in the Property drop-down list, select Signal sum, and in the Type drop-down list, select Maximize the property.

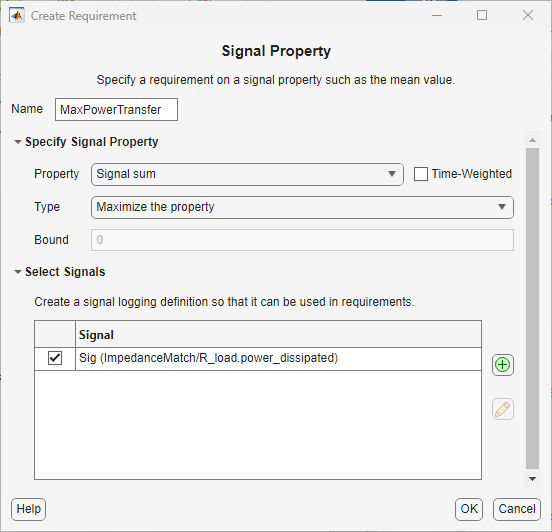

The Create Requirement dialog box showing the specified signal property and the selected signal

In addition to specifying that the goal of the optimization is to maximize the power transferred to the load, you also need to specify the design variables to tune to achieve that goal. In the Response Optimization tab, in the Design Variables Set drop-down list, select New. In the Create Design Variables Set dialog box, click the variable R_load, and click the 'C' button to select R_load as a continuous design variable. Since the resistance cannot be negative, in the top left table, specify the value of Minimum as 0 and click OK.

The Create Design Variables Set dialog box showing the selected continuous variable, R_load

Optimize the Model

In the Response Optimization tab, click Optimize. This varies the design variable, R_load, over multiple iterations. The power transferred from the source to the load increases with each iteration until it reaches a maximum. In the Response Optimization tab, in the Add Plot drop-down list, select Parameter Trajectory. Two plots, the value of the design variable (R_load) over time and the value of the maximum power transferred over time, appear in the app. Adjust the tabs of all the plots so that you can view them together.

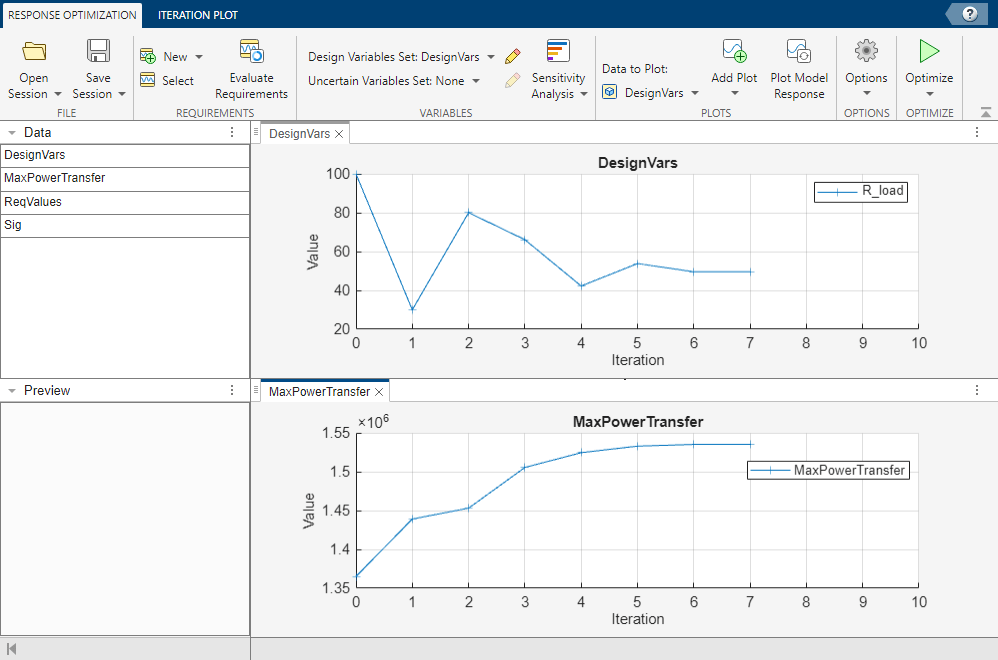

The Response Optimizer app displaying the parameter trajectory plots

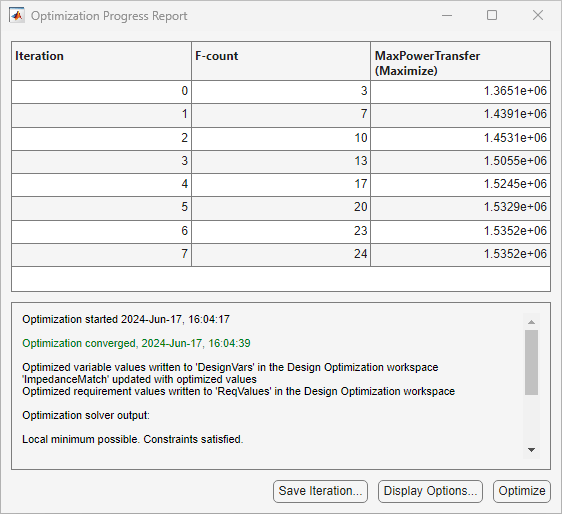

The Optimization Progress Report dialog box

By the end of the optimization, you can see that R_load has a value of 50 ohms, which is the same as the source resistance, Rs. This agrees with the long established result that for maximum power transfer, the load impedance should match the source impedance. In this case, you can find the optimal load resistance analytically without performing numerical simulation. However, in many applications, finding an analytical solution is not feasible and numerical methods are necessary.

So in this example, you can see that when the optimization requirements are connected with Simscape signals, Simulink Design Optimization interacts directly with Simscape.

See Also

Topics
